What Is Critical Chain Project Management?

Critical Chain Project Management (CCPM) is a method for planning, scheduling, and controlling projects by considering both activity dependencies and resource availability while using shared buffers to manage uncertainty.

Unlike scheduling approaches that focus primarily on activity sequence and duration, the method explicitly considers whether the required people, equipment, or other constrained resources can actually perform scheduled activities when needed. For this reason, CCPM is particularly useful for understanding resource constraints in project management and their effect on realistic project schedules.

critical chain project management (CCPM)

CCPM is closely associated with Eliyahu M. Goldratt, who popularized the approach through his work on the Theory of Constraints and the 1997 book Critical Chain. The central idea is that a project schedule should not assume that every required resource will automatically be available simply because activities could logically occur at the same time.

For example, two activities may have no dependency between them and therefore appear capable of running simultaneously. If both require the same engineer, however, they cannot actually occur at the same time. CCPM resolves this resource conflict before identifying the schedule-driving chain.

This resource-aware perspective complements broader approaches to planning and controlling project time and schedule, particularly where limited resources create delays that are not visible from activity dependencies alone.

Critical Chain Method in Project Management

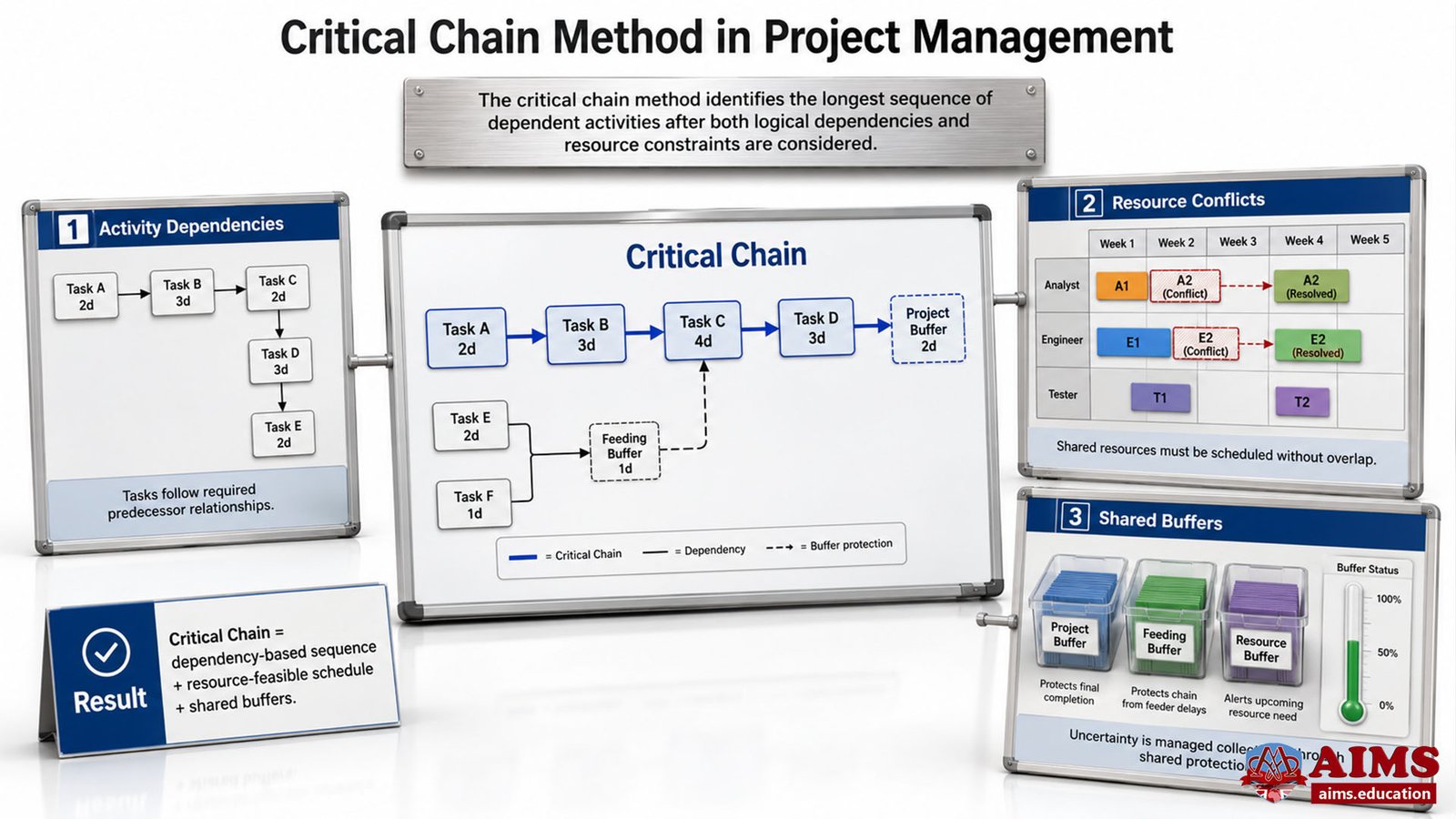

The critical chain method in project management identifies the longest sequence of dependent activities after both logical dependencies and resource constraints have been considered.

The critical chain therefore differs from a purely dependency-driven schedule. It represents the sequence of work that determines project duration once the project team has created a feasible resource schedule.

Three factors are central to the method:

  • Activity dependencies must be respected. A task cannot start until its required predecessor work has been completed.
  • Resource conflicts must be resolved. The same person, team, machine, or specialist cannot perform multiple incompatible activities simultaneously.
  • Schedule uncertainty must be managed collectively. Instead of placing generous contingency inside every activity estimate, CCPM protects important paths through shared buffers.
critical chain method in project management

A well-constructed project network diagram showing activity relationships provides the logical foundation. CCPM then adds resource feasibility before the critical chain is finalized.

How Does Critical Chain Project Management Work?

CCPM works by building the project schedule, resolving resource conflicts, identifying the critical chain, adding protective buffers, executing work with focused resources, and monitoring buffer consumption throughout the project.

The process can be understood through seven practical steps:

  1. Define activities and dependencies. Identify the work required and determine the logical sequence between activities.
  2. Estimate activity durations. Use realistic but challenging durations instead of allowing excessive safety time to accumulate within individual task estimates.
  3. Identify resource requirements. Determine which people, equipment, facilities, or specialized capabilities each activity needs.
  4. Resolve resource conflicts. Adjust the schedule when two activities require the same constrained resource at the same time.
  5. Identify the critical chain. Find the longest resource-feasible chain that determines the project’s completion time.
  6. Add protective buffers. Protect the project and critical chain from uncertainty using project and feeding buffers, while resource buffers support timely resource readiness.
  7. Manage execution through buffer status. Monitor how much protective buffer has been consumed relative to project progress and intervene when necessary.

Many CCPM implementations replace highly conservative task estimates with more aggressive estimates that may represent roughly a 50 percent probability of individual task completion. The removed safety is then aggregated into shared buffers. This should not be interpreted as a universal rule requiring every activity duration to be mechanically cut in half.

The overall objective is to improve project flow rather than encourage every resource to appear continuously busy. This principle is particularly important where multitasking causes repeated switching, interrupted work, and delayed completion.

What Are Buffers in Critical Chain Project Management?

Critical chain buffers are protective mechanisms used to absorb schedule variability and prevent individual delays from automatically changing the committed project completion date.

The three commonly discussed buffer types are:

  • Project buffer
  • Feeding buffer
  • Resource buffer

Project Buffer

A project buffer is time placed after the final activity on the critical chain and before the committed project completion date.

It protects the overall completion date from uncertainty affecting critical-chain activities. If activities on the critical chain take longer than planned, part of the buffer is consumed. If activities finish earlier, more protection remains available for later uncertainty.

The project buffer is therefore not an additional project activity. It is shared schedule protection for the project as a whole.

Feeding Buffer

A feeding buffer is time placed where a non-critical sequence of activities feeds into the critical chain.

Its purpose is to prevent delays on a feeding path from immediately delaying critical-chain work. Without this protection, a relatively unimportant activity outside the critical chain could become late and disrupt a schedule-driving activity at the point where the paths merge.

Resource Buffer

A resource buffer is primarily a readiness or warning mechanism used to ensure that a critical resource is prepared when an important critical-chain activity is ready to begin.

Unlike project and feeding buffers, a resource buffer should not simply be understood as extra schedule time or as an additional person or piece of equipment. In practice, it can operate as an advance notification or management signal that prepares a scarce resource for upcoming critical-chain work.

BUFFER TYPEPURPOSEPLACEMENT OR USE
Project BufferProtects the committed project completion date from uncertainty affecting the critical chain.Placed after the final critical-chain activity and before the project delivery date.
Feeding BufferProtects the critical chain from delays occurring on non-critical feeding paths.Placed where a non-critical activity chain joins the critical chain.
Resource BufferHelps ensure that a constrained or important resource is ready when required.Used as a readiness signal before resource-sensitive critical-chain work.
Comparison of project, feeding, and resource buffers used in Critical Chain Project Management.

Buffer Management in CCPM

Buffer management controls a CCPM schedule by monitoring how rapidly protective buffers are being consumed as project work progresses.

Rather than treating every late individual task as a crisis, managers evaluate whether the delay is threatening the shared protection available to the project. This helps management focus attention where schedule risk is actually becoming significant.

  • Low buffer consumption generally indicates adequate protection. Normal project variability may not require corrective action.
  • Increasing consumption signals rising schedule risk. Managers should investigate the activities or resources driving the loss of protection.
  • High consumption requires focused recovery action. Priority should be given to protecting project completion rather than optimizing isolated task performance.

This approach turns the buffer into a control mechanism rather than simply unused contingency time.

How Does CCPM Manage Resource Constraints?

CCPM manages resource constraints by making resource availability part of the schedule before the critical chain is determined.

Suppose two technically independent activities require the same specialist. A dependency-only schedule could place both activities at the same time. CCPM recognizes that this plan is impossible and sequences the activities according to actual resource availability.

This produces a resource-feasible schedule and reveals constraints that may otherwise remain hidden until execution begins.

CCPM also discourages unnecessary multitasking. When scarce specialists repeatedly move among several partially completed tasks, work may remain open for longer and projects can lose flow. CCPM therefore emphasizes focused completion and controlled release of work.

Critical Chain Project Management and the Theory of Constraints

CCPM applies the logic of the Theory of Constraints to project environments by focusing management attention on the constraint that governs overall project flow.

Theory of Constraints project management begins from a system-level idea: improving every activity independently does not necessarily improve the performance of the entire project. Management should instead identify what limits overall flow and organize work around that constraint.

Within CCPM, this thinking influences:

  • Resource prioritization. Scarce resources are protected from conflicting demands that could delay schedule-driving work.
  • Reduced multitasking. Teams are encouraged to finish priority work before switching unnecessarily to another task.
  • Shared schedule protection. Uncertainty is aggregated into buffers rather than scattered as hidden safety across individual activities.
  • System-level control. Management decisions focus on overall project delivery rather than whether every individual activity meets an artificial local deadline.

This makes CCPM one specialized approach within the wider family of top project management methodologies.

Merits and Demerits of Critical Chain Scheduling

Critical chain scheduling can improve schedule realism and resource coordination, but its effectiveness depends on suitable projects, reliable resource information, and disciplined execution.

AREAMERITSLIMITATIONS
Resource PlanningResource conflicts are considered before the final schedule is established.Reliable information about resource availability and capability is required.
Schedule ProtectionShared buffers protect important schedule commitments from normal variability.Poor buffer sizing can create either insufficient protection or unnecessary schedule allowance.
Team FocusReducing unnecessary multitasking can improve continuity of work.The approach may require behavioral and organizational changes that teams initially resist.
Project ControlBuffer consumption provides an early indication that schedule protection is being lost.Managers must understand buffer signals instead of reacting mechanically to every late activity.
SuitabilityCCPM is valuable where scarce resources and schedule uncertainty strongly influence delivery.The additional scheduling discipline may offer limited value for very small or straightforward projects.
Major advantages and limitations of Critical Chain Project Management and critical chain scheduling.

CCPM should therefore be treated as a management methodology rather than a guarantee of faster delivery. Its results depend on the project environment, implementation quality, organizational behavior, and the nature of the constraints involved.

Critical Chain Project Management Example

A useful CCPM example is a project in which two independent activities appear capable of running simultaneously but actually depend on the same scarce specialist.

Example of Resource-Constrained Critical Chain Scheduling

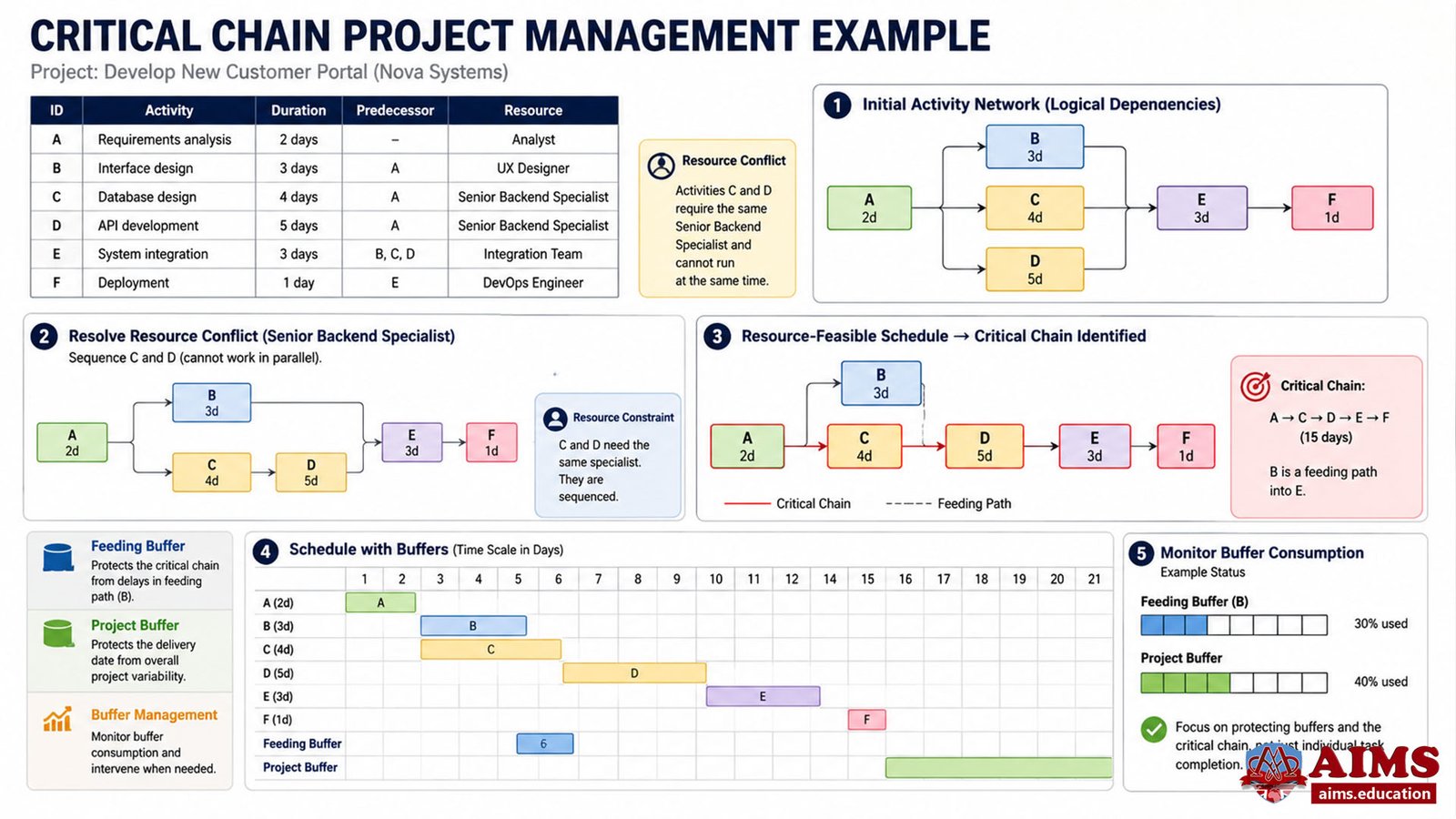

Imagine that Nova Systems is developing a new customer portal. Its simplified schedule contains the following work:

  • Activity A: Requirements analysis takes 2 days.
  • Activity B: Interface design takes 3 days after requirements are completed.
  • Activity C: Database design takes 4 days after requirements are completed.
  • Activity D: API development takes 5 days after requirements are completed.
  • Activity E: System integration takes 3 days after the interface, database, and API work are complete.
  • Activity F: Deployment takes 1 day after integration.
CCPM project management example

At first, Activities C and D appear capable of occurring in parallel because neither depends on the other. However, both require the same senior backend specialist.

  1. The team first maps the logical dependencies. This produces the initial activity network.
  2. The resource conflict is then identified. The backend specialist cannot perform database design and API development simultaneously.
  3. Activities C and D are therefore sequenced. The resource dependency becomes part of the realistic schedule.
  4. The resource-feasible sequence helps define the critical chain. The apparent parallelism disappears because the shared specialist is constrained.
  5. A feeding buffer protects the critical chain from delays in interface design. It is positioned before that feeding work joins integration.
  6. A project buffer is placed after the final critical-chain activity. This protects the committed delivery date from accumulated variability.
  7. During execution, management monitors buffer consumption. Intervention is based on the threat to project completion rather than isolated task lateness alone.

The example shows how CCPM converts a hidden resource conflict into an explicit, protectable schedule constraint.

Critical Chain vs Critical Path

The main difference in critical chain vs critical path analysis is that the Critical Path Method identifies the longest dependency-driven path, whereas CCPM determines a resource-feasible critical chain after resource constraints are incorporated into the schedule.

The two concepts are related, but critical chain is not simply another name for critical path. Guide on Critical Path Method makes the distinction clearer.

COMPARISONCRITICAL PATH METHODCRITICAL CHAIN PROJECT MANAGEMENT
Primary FocusActivity durations and logical dependencies.Logical dependencies, resource constraints, project flow, and uncertainty.
Schedule-Driving SequenceThe longest dependency-based path through the project network.The longest resource-feasible chain after resource conflicts are resolved.
Resource ConstraintsNot inherently part of the basic critical-path calculation, although resource analysis can be applied separately.Explicitly considered before the critical chain is finalized.
UncertaintyMay be managed through activity estimates, contingency, reserves, or other schedule-risk techniques.Commonly consolidates schedule protection into project and feeding buffers.
MultitaskingDoes not inherently prescribe a specific behavior for reducing resource multitasking.Actively seeks to reduce harmful multitasking around constrained resources.
Schedule ControlProgress is commonly assessed against scheduled activity dates, milestones, and path status.Buffer consumption becomes an important indicator of schedule health.
Critical Chain versus Critical Path comparison based on dependencies, resource constraints, uncertainty, and schedule control.

In practice, both approaches seek to identify what can determine project completion. CCPM extends this scheduling logic by making constrained-resource availability and shared schedule protection central to the management system.

When Should Critical Chain Project Management Be Used?

CCPM is most useful when project delivery depends heavily on scarce shared resources, uncertain activity durations, competing project priorities, or excessive multitasking.

It is particularly relevant when:

  • Several activities compete for the same specialist resources. Resource conflicts materially affect the achievable schedule.
  • Multiple projects share a limited resource pool. Frequent priority changes create start-stop work and delayed completion.
  • Deadline reliability is important. Management needs visible shared protection against schedule variability.
  • Task estimates contain substantial hidden safety. Aggregating uncertainty may provide a clearer project-level control mechanism.
  • Multitasking is reducing project flow. Teams need clearer rules for prioritizing and finishing work.

CCPM may be less useful for extremely small projects with few dependencies and no meaningful resource competition. It also requires careful adaptation in highly exploratory environments where work is intentionally reprioritized frequently.

Organizations comparing predictive, adaptive, and mixed delivery environments may also benefit from reviewing how Agile, Waterfall, and Hybrid project approaches differ. CCPM can complement some delivery environments, but it should not automatically be treated as an Agile method.

Professional Relevance of CCPM

CCPM develops practical understanding of schedule analysis, constrained-resource allocation, uncertainty management, and project control.

These capabilities are relevant to project managers responsible for complex schedules, shared teams, specialist resources, or multi-project environments. They also connect closely with approaches to identify and control project risk, because buffer consumption can reveal when uncertainty is beginning to threaten delivery commitments.

Professionals developing broader competence can study these concepts through best online certificate course in project management, progress into an advanced project management diploma that include Project, Program and Project Portfolio Management trainings, or integrate scheduling and resource-management knowledge into Masters Level MBA degree in project management study.

Final Words on Critical Chain Project Management

Critical Chain Project Management provides a resource-aware approach to project scheduling and control. Its distinctive contribution is not merely identifying a long chain of activities. It combines logical dependencies, constrained-resource availability, reduced multitasking, shared schedule protection, and buffer-based control into one management approach.

The method is particularly valuable when resource conflicts and uncertainty determine whether a project can meet its promised completion date. However, CCPM should be selected because it fits the project environment, not because its benefits are assumed to be universal.

Frequently Asked Questions

What is Critical Chain Project Management?

Critical Chain Project Management is a project planning and control approach that considers activity dependencies, resource constraints, and schedule uncertainty. It protects important project commitments through shared buffers and emphasizes focused use of constrained resources.

How does Critical Chain Project Management work?

CCPM builds the activity network, identifies resource requirements, resolves resource conflicts, determines the resource-feasible critical chain, adds protective buffers, and monitors buffer consumption during execution.

What is the difference between critical chain and critical path?

The critical path is primarily determined from activity durations and logical dependencies. The critical chain is established after resource constraints are incorporated, making it a resource-feasible sequence of schedule-driving work.

What are the steps in the Critical Chain Method?

The main steps are defining activities and dependencies, estimating durations, assigning resources, resolving resource conflicts, identifying the critical chain, adding buffers, and controlling execution through buffer status.

What are buffers in Critical Chain Project Management?

Buffers protect the project schedule from uncertainty. Project buffers protect the overall completion date, feeding buffers protect the critical chain from delays on feeding paths, and resource buffers help ensure important resources are ready when needed.

What is a project buffer in CCPM?

A project buffer is shared schedule protection placed after the last activity on the critical chain and before the committed completion date. Delays on critical-chain work can consume this buffer without immediately changing the promised delivery date.

What is the difference between project, feeding, and resource buffers?

A project buffer protects final project completion, while a feeding buffer protects the critical chain where a non-critical path joins it. A resource buffer is primarily a readiness signal that helps ensure a required constrained resource is available for critical-chain work.

How does CCPM manage resource constraints?

CCPM identifies resource conflicts before finalizing the schedule. When two activities need the same limited resource, they are scheduled in a feasible sequence rather than being treated as if they could automatically occur simultaneously.

How is Critical Chain Project Management related to the Theory of Constraints?

CCPM applies Theory of Constraints thinking to projects by focusing on factors that restrict overall project flow. It emphasizes constrained resources, focused work, reduced multitasking, and system-level performance rather than isolated task optimization.

What are the advantages and disadvantages of Critical Chain Project Management?

Advantages include more realistic resource scheduling, shared protection against uncertainty, reduced multitasking, and buffer-based early warning. Limitations include implementation complexity, dependence on reliable resource information, buffer-sizing judgment, and the organizational discipline required to change established work habits.

How do you identify the critical chain in a project?

First create the activity network and identify logical dependencies. Then assign resources and resolve conflicts so that the schedule becomes resource-feasible. The longest sequence governing completion after these constraints are incorporated becomes the critical chain.

When should Critical Chain Project Management be used?

CCPM is most appropriate when scarce resources, multitasking, schedule uncertainty, and competing priorities strongly influence delivery. It can be especially useful in complex or multi-project environments where several projects depend on the same constrained resources.
