What Is the Critical Path Method in Project Management?
The Critical Path Method is a network-based scheduling technique that calculates project duration, activity timing, schedule flexibility, and the sequence of activities that directly controls the project completion date.
The critical path method in project management begins with activities, their durations, and their logical dependencies. These activities are connected in a network, after which critical path analysis determines the earliest and latest times each activity can occur without changing the required completion date.
- In practice, the critical path in project management helps project managers focus attention on activities that control the schedule.
- It also supports deadline analysis, schedule optimization, resource decisions, and early identification of potential delays.
- Understanding CPM is therefore useful not only for preparing a project schedule, but also for controlling it as work progresses.
CPM normally provides four important schedule values for each activity:
- Early Start (ES) is the earliest time an activity can begin after its predecessors are completed.
- Early Finish (EF) is the earliest time the activity can be completed.
- Late Start (LS) is the latest time the activity can begin without delaying the project completion date.
- Late Finish (LF) is the latest time the activity can finish without delaying the project completion date.
These values are then used to calculate float and identify the activities that require the closest schedule control.
What Is a Critical Path in a Project?
The critical path is the longest-duration path through the project activity network and establishes the earliest possible completion time under the schedule’s current activity durations and dependencies.
This definition sometimes causes confusion. The critical path is the longest path through the network, but its duration also represents the minimum time in which the whole project can be completed under the current scheduling assumptions.
The critical path is not the shortest path through a project. It is the longest-duration network path that determines the project’s earliest possible completion.
Simple Critical Path Method Example

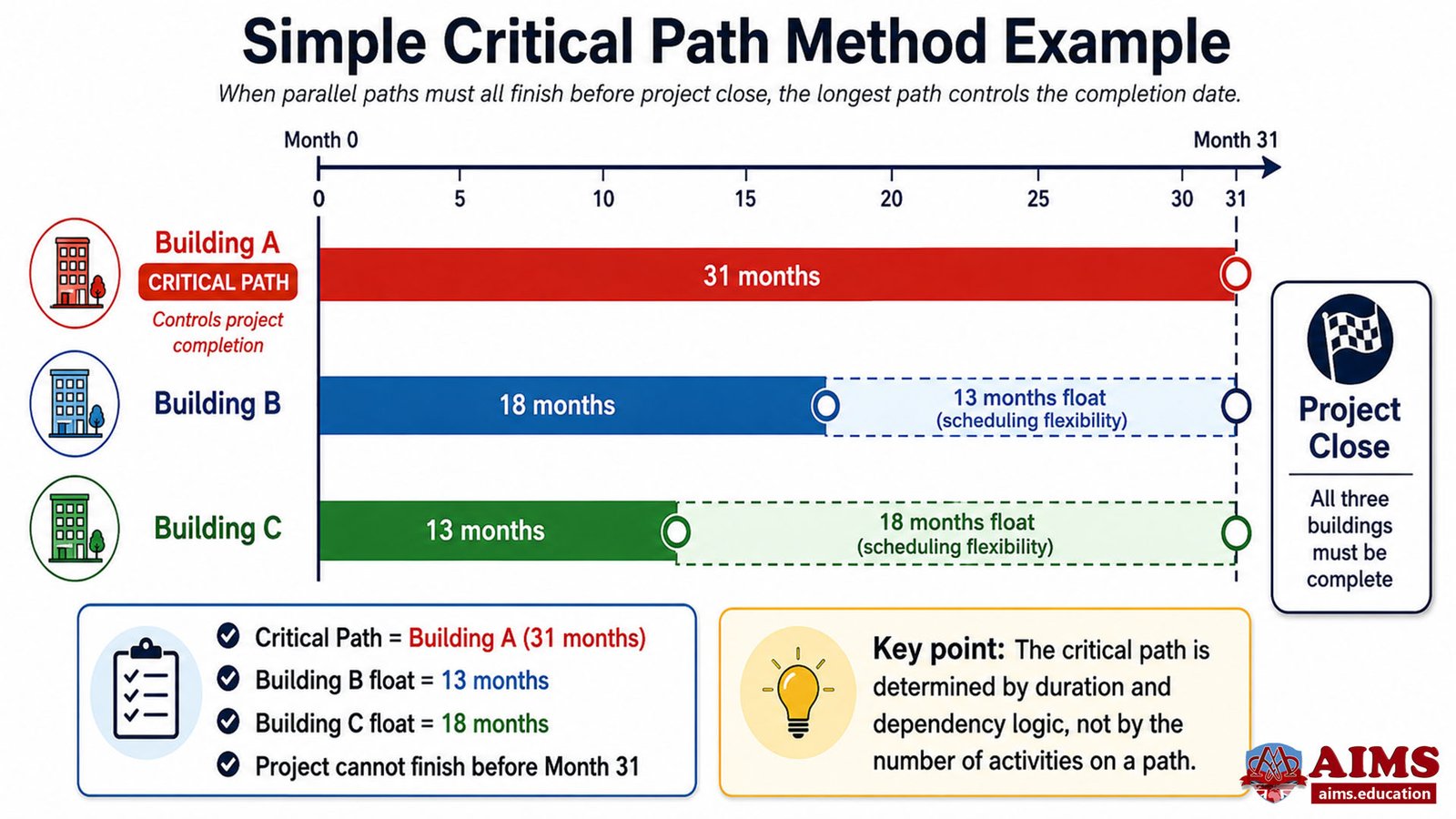

Suppose an organization is constructing three buildings as parallel parts of one project:
- Building A requires 31 months.
- Building B requires 18 months.
- Building C requires 13 months.
If all three buildings must be finished before the project can close, the 31-month path controls the completion date. It is therefore the critical path.
The 18-month path has 13 months of scheduling flexibility relative to the project completion date, while the 13-month path has 18 months. The project still cannot finish before month 31 because the longest path remains incomplete until then.
This illustrates an important distinction: the critical path is determined by duration and dependency logic, not simply by the number of activities on a path.
How Does the Critical Path Method Work?
CPM works by connecting project activities according to their dependencies, calculating the timing of each activity, measuring available float, and identifying the sequence with no scheduling flexibility.
A practical CPM analysis normally requires the following information:
- A complete list of schedule activities must be identified.
- Each activity must have an estimated duration.
- Predecessor and successor relationships must be defined.
- The activities must be organized into a logical network.
- Forward and backward calculations must establish early and late schedule dates.
- Total float must be calculated to identify critical activities.
A properly developed critical path diagram therefore shows more than task order. It demonstrates how dependencies combine to determine the overall project duration.
How to Find and Calculate the Critical Path in Project Management

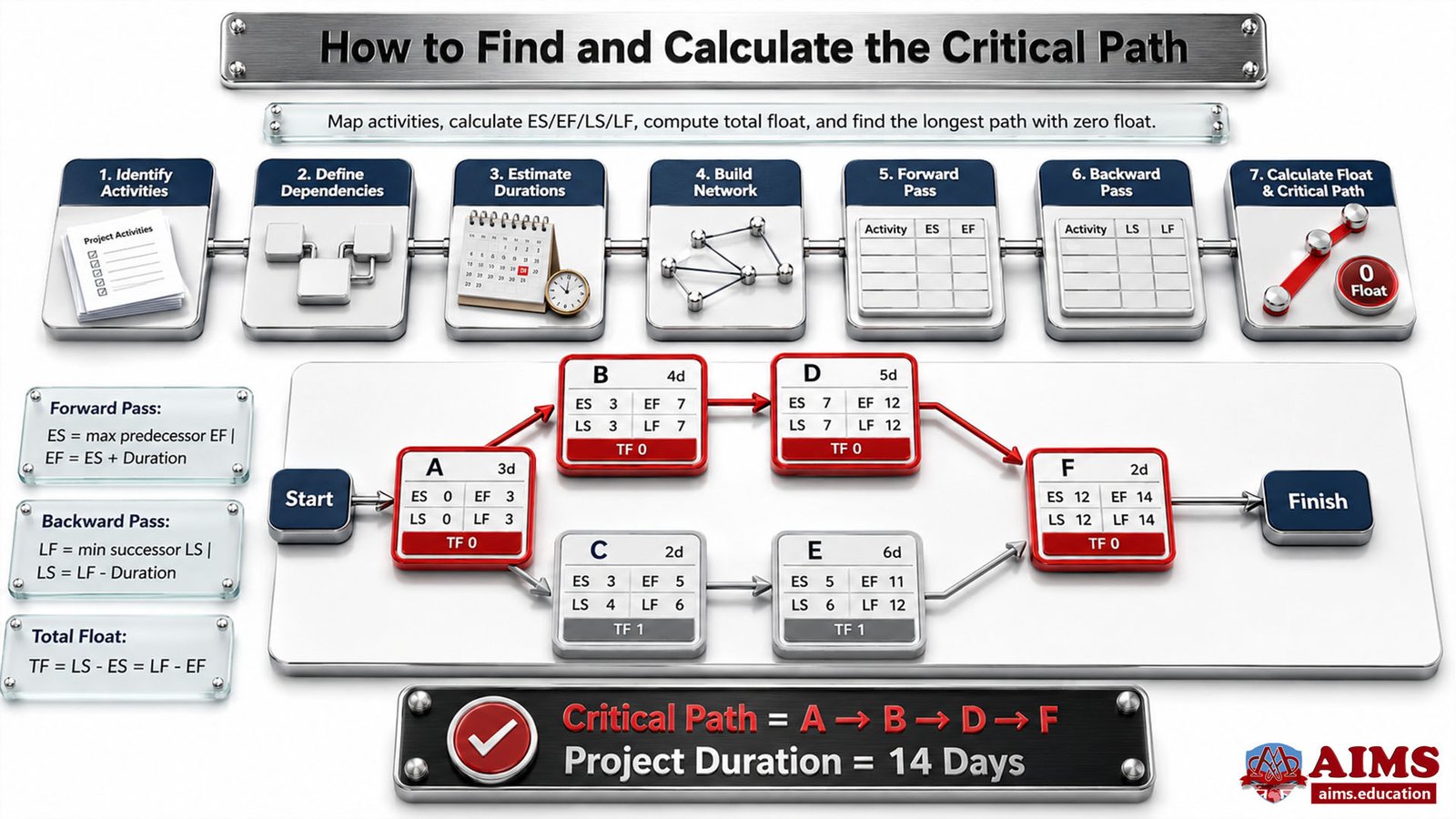

To find the critical path in project management, identify the project activities, define their dependencies and durations, create the schedule network, perform forward and backward passes, calculate total float, and identify the continuous path of activities with zero total float.
- Identify the project activities. Begin by decomposing the project deliverables into manageable work. A work breakdown structure for defining project activities can help establish the work that must eventually be scheduled.
- Estimate activity durations. Determine a realistic duration for every scheduled activity using historical information, expert judgment, organizational data, or another suitable estimation method.
- Define activity dependencies. Establish which activities must occur before or after others. Incorrect dependency logic can produce a technically correct calculation for an incorrect schedule.
- Create the network. Represent the logical relationships visually. Understanding how to construct a project schedule network diagram and activity dependencies is particularly useful at this stage.
- Perform the forward pass. Calculate Early Start and Early Finish values from the beginning of the network to the end.
- Perform the backward pass. Calculate Late Finish and Late Start values from the project completion point back toward the beginning.
- Calculate total float. Compare the early and late schedule values to determine how much an activity can move without delaying project completion.
- Identify the critical path. In a basic unconstrained CPM network, the continuous sequence of activities with zero total float forms the critical path.
For a small network, you can also identify all complete paths and compare their durations. For a large project, however, calculating activity dates and float is much more practical than manually enumerating every possible path.
Critical Path Method Example: Worked Network Calculation
This example calculates the critical path for a nine-activity project with several parallel and converging dependencies.
The activities and durations are:
| ACTIVITY | PREDECESSOR | DURATION |
|---|---|---|
| A | None | 10 days |
| D | None | 5 days |
| G | None | 3 days |
| B | A and D | 12 days |
| E | D and G | 7 days |
| H | G | 4 days |
| C | B | 9 days |
| F | E | 6 days |
| I | H | 6 days |
Step 1: Identify the Possible Paths
The network contains five complete paths:
| PATH | CALCULATION | PATH DURATION |
|---|---|---|
| A → B → C | 10 + 12 + 9 | 31 days |
| D → B → C | 5 + 12 + 9 | 26 days |
| D → E → F | 5 + 7 + 6 | 18 days |
| G → E → F | 3 + 7 + 6 | 16 days |
| G → H → I | 3 + 4 + 6 | 13 days |
The A → B → C path has the longest duration at 31 days. It is therefore the critical path, and the earliest possible project completion time is 31 days.
For learning purposes, subtracting another complete path’s duration from 31 days provides an intuitive indication of how much shorter that path is. However, formal critical path calculation should determine float at the activity level through forward and backward passes, particularly where paths share or merge activities.
Calculating the Forward Pass and Backward Pass
The forward pass determines the earliest possible timing of activities, while the backward pass determines how late activities can occur without delaying project completion.
For clarity, this example uses a day-zero convention. Under this convention, an activity beginning immediately has an Early Start of 0. Calendar-based scheduling systems may display dates differently, but the dependency logic remains the same.
Forward Pass: Early Start and Early Finish
The basic critical path formula for a forward pass is:
- Early Finish = Early Start + Activity Duration.
- When an activity has one predecessor, its Early Start equals the predecessor’s Early Finish.
- When an activity has several predecessors, its Early Start equals the highest Early Finish among those predecessors.
For example, Activity B cannot begin until both A and D are complete. Activity A finishes at day 10 and Activity D finishes at day 5. Therefore, B must wait for A and has an Early Start of day 10.
Backward Pass: Late Finish and Late Start
The backward-pass formulas are:
- Late Start = Late Finish − Activity Duration.
- When an activity has one successor, its Late Finish equals the successor’s Late Start.
- When an activity has several successors, its Late Finish equals the lowest Late Start among those successors.
The calculation begins at the 31-day project completion point and moves backward through the network.
Complete CPM Calculation
| ACTIVITY | DURATION | ES | EF | LS | LF | TOTAL FLOAT |
|---|---|---|---|---|---|---|
| A | 10 | 0 | 10 | 0 | 10 | 0 |
| D | 5 | 0 | 5 | 5 | 10 | 5 |
| G | 3 | 0 | 3 | 15 | 18 | 15 |
| B | 12 | 10 | 22 | 10 | 22 | 0 |
| E | 7 | 5 | 12 | 18 | 25 | 13 |
| H | 4 | 3 | 7 | 21 | 25 | 18 |
| C | 9 | 22 | 31 | 22 | 31 | 0 |
| F | 6 | 12 | 18 | 25 | 31 | 13 |
| I | 6 | 7 | 13 | 25 | 31 | 18 |
Activities A, B, and C each have zero total float. They form the critical path A
→ B → C, with a project duration of 31 days.
What Is Float or Slack in the Critical Path Method?
Float, also called slack, is the amount of scheduling flexibility available before an activity causes a specified schedule impact.
Understanding critical path and float together is essential because CPM does not only identify what is critical. It also shows where schedule flexibility exists.
Total Float
Total float is the amount of time an activity can be delayed without delaying the project’s scheduled completion date.
The formula is:
Total Float = Late Start − Early Start
or:
Total Float = Late Finish − Early Finish
For Activity D in the example:
- Early Start = 0.
- Late Start = 5.
- Total Float = 5 − 0 = 5 days.
Activity D can therefore move by up to five days before it begins to affect the project’s completion date, assuming the rest of the network remains unchanged.
Free Float
Free float is the amount of time an activity can be delayed without delaying the Early Start of an immediate successor.
This distinction is important when studying slack in project management. An activity may possess total float but little or no free float because delaying it could shift another activity without yet delaying the overall project.
Critical vs Non-Critical Activities
Critical activities directly control the calculated project completion date, while non-critical activities possess some scheduling flexibility before they affect that date.
| ATTRIBUTE | CRITICAL ACTIVITIES | NON-CRITICAL ACTIVITIES |
|---|---|---|
| Total Float | Typically zero in a basic unconstrained CPM network. | Normally greater than zero. |
| Scheduling Flexibility | Little or no flexibility exists without affecting project completion. | Some movement is possible within available float. |
| Delay Impact | A delay normally delays project completion unless corrective action or offsetting changes occur. | A delay may consume float before affecting project completion. |
| Management Priority | Requires close schedule monitoring and rapid response to emerging delays. | Requires monitoring because accumulated delays may reduce float and eventually make the activity critical. |
| Meaning of Critical | Critical refers to schedule impact, not simply business importance. | A non-critical activity can still be operationally, financially, or strategically important. |
A common misconception is that a critical activity is simply an important task. In CPM, the term has a precise scheduling meaning. A highly important task may be non-critical if it has float, while an ordinary activity may become critical because its timing directly controls project completion.
Why Is the Critical Path Important in Project Management?
The critical path is important because it identifies which activities control the project deadline and where management attention can have the greatest effect on schedule performance.
CPM supports several areas of time management in project management:
- It establishes the earliest possible completion date based on current schedule logic and duration estimates.
- It identifies activities that require the closest monitoring.
- It reveals where schedule flexibility exists through float.
- It helps managers evaluate the consequences of proposed schedule changes.
- It supports decisions about schedule compression and resource attention.
- It improves communication by making activity dependencies and timing consequences visible.
Applications of Critical Path Scheduling
Critical path scheduling can be applied wherever work contains identifiable activities, durations, and dependencies.
- In construction, CPM can connect excavation, foundations, structural work, installation, inspection, and handover activities.
- In software projects, it can identify dependencies between architecture, development, integration, testing, security approval, and deployment.
- In manufacturing, it can coordinate procurement, tooling, production, inspection, packaging, and delivery activities.
- In events, it can connect venue approval, supplier contracting, production, setup, rehearsals, and event delivery.
Project managers who want structured professional development in scheduling, planning, risk, and control can also study these capabilities through a career-focused Certified Project Manager certificate with PMP Training.
Can a Project Have More Than One Critical Path?
Yes. A project can have two or more critical paths when multiple network paths have the same controlling duration or possess no usable total float.
Multiple critical paths increase schedule exposure because a delay on any one of them may affect the project completion date. Management attention is therefore divided across several sequences rather than concentrated on one.
Near-critical paths also deserve attention. A path with only one or two days of float may become critical after a relatively small delay.
Can the Critical Path Change During a Project?
Yes. The critical path can change when actual progress, remaining durations, dependencies, constraints, or schedule forecasts change.
Suppose a non-critical activity initially has five days of total float. If it is delayed by four days, only one day of float remains. A further delay may cause its path to become critical.
For this reason, CPM should not be treated as a one-time planning exercise. The network must be updated as actual performance becomes known.
What Happens When a Critical Path Activity Is Delayed?
A delay to a critical activity normally moves the project completion date by the same amount unless the delay is recovered elsewhere or the schedule logic changes.
Project managers should first determine the cause and forecast impact. The delay should then be incorporated into broader planning risk management in projects before corrective action is selected.
Schedule Compression: Fast-Tracking and Crashing
Two commonly used responses are fast-tracking and crashing:
- Fast-tracking overlaps activities that were originally planned sequentially where the work permits this. It can shorten the schedule but may increase coordination, rework, and execution risk.
- Crashing adds resources or incurs additional cost to shorten selected activity durations where a meaningful time reduction is technically possible.
Schedule compression should focus on activities that currently control project completion. Shortening an activity with substantial float will not necessarily shorten the overall project.
CPM vs PERT: What Is the Difference?
CPM primarily analyzes schedule logic using defined activity durations, while PERT emphasizes uncertainty by estimating activity time from optimistic, most likely, and pessimistic duration estimates.
| COMPARISON | CPM | PERT |
|---|---|---|
| Primary Focus | Network logic, critical path, project duration, and float. | Duration uncertainty and expected activity time. |
| Duration Input | Usually uses a defined duration for each activity in the basic calculation. | Uses optimistic, most likely, and pessimistic estimates. |
| Expected-Time Formula | The scheduled duration is used directly in the network calculation. | Expected Time = (Optimistic + 4 × Most Likely + Pessimistic) ÷ 6. |
| Best Use | Useful where dependencies can be defined and workable activity-duration estimates are available. | Useful when duration uncertainty deserves explicit consideration. |
| Main Output | Critical path, project duration, activity timing, and float. | Expected durations that can be incorporated into schedule analysis. |
CPM and PERT should not always be treated as mutually exclusive alternatives. A project team may use three-point estimates to address uncertainty and then apply network analysis to determine the resulting critical path.
Benefits of the Critical Path Method
The main benefit of CPM is that it converts a collection of project activities into a logical schedule that shows what controls completion and where flexibility remains.
- CPM makes important activity dependencies visible.
- It identifies the calculated project duration and critical sequence.
- It distinguishes critical work from activities possessing schedule flexibility.
- It helps managers prioritize schedule monitoring and corrective action.
- It supports contingency analysis and schedule-compression decisions.
- It provides a useful basis for communicating schedule consequences to stakeholders.
Limitations of the Critical Path Method
CPM is only as reliable as the activity definitions, duration estimates, dependency logic, constraints, and schedule updates on which the calculation is based.
- Duration estimates can be uncertain. An apparently precise 31-day schedule is still based on assumptions about how long activities will actually take.
- Dependency errors distort the result. Missing or unnecessary logical relationships can create a misleading critical path.
- Resource constraints require additional analysis. Basic CPM calculations identify logic-driven schedule relationships but do not automatically resolve situations where several activities require the same limited resource.
- Large networks become complex. Projects containing hundreds or thousands of activities normally require scheduling software and disciplined schedule governance.
- The critical path is dynamic. Progress and schedule changes may create a new critical path, so an outdated calculation can lead to poor decisions.
- Deterministic calculations do not eliminate uncertainty. Risk analysis, alternative scenarios, and suitable estimating methods may still be necessary.
Where resource availability is a dominant scheduling constraint, it is useful to compare CPM with Critical Chain Project Management and resource-constrained scheduling, which places greater emphasis on resource constraints and schedule buffers.
Best Practices for Managing the Critical Path
Effective critical path management requires continuous schedule review rather than simply calculating the critical path once during project planning.
- Validate the network logic. Confirm that predecessors and successors reflect how the work will actually be performed.
- Use realistic duration estimates. Update estimates when better information becomes available instead of protecting outdated assumptions.
- Monitor critical and near-critical activities. A non-critical path with little remaining float can quickly become critical.
- Track changes in total float. Declining float can provide an early warning before the final completion date begins to move.
- Connect schedule analysis with risk management. Give particular attention to uncertainty affecting activities that control or nearly control completion.
- Update the schedule with actual progress. Recalculate the network when activity dates, durations, dependencies, or constraints change.
- Use software without surrendering judgment. Modern scheduling applications can automate complex calculations, but managers must still understand why an activity is critical. A structured comparison of project management software and scheduling tools can help when selecting suitable technology.
The practical objective is not simply to identify a red line on a schedule. It is to understand what currently drives project completion and what management action will protect or improve that date.
Final Words on Critical Path Analysis
The Critical Path Method provides project managers with a disciplined way to connect activity dependencies, duration estimates, project completion, and schedule flexibility. Its central idea is simple: the longest-duration sequence through the network determines when the project can finish, while forward and backward calculations reveal which activities possess float.
CPM becomes most valuable when the schedule is actively maintained. Critical paths can change, near-critical work can lose float, and inaccurate assumptions can undermine even a mathematically correct schedule.
For professionals who want to develop these scheduling capabilities alongside broader project, program, and portfolio management knowledge, AIMS provides a accredited online diploma for career-focused project management practice.
Frequently Asked Questions
What is the Critical Path Method in project management?
The Critical Path Method is a scheduling technique used to calculate project duration, activity timing, float, and the sequence of dependent activities that controls the project completion date.
What is a critical path in a project?
The critical path is the longest-duration sequence through the project activity network. Its duration establishes the earliest possible project completion under the current schedule logic and duration estimates.
How do you find the critical path in project management?
List the activities, estimate their durations, define dependencies, construct the activity network, perform forward and backward passes, calculate total float, and identify the continuous sequence of activities with zero total float.
How do you calculate the critical path step by step?
First calculate Early Start and Early Finish with a forward pass. Then calculate Late Finish and Late Start with a backward pass. Calculate total float as LS − ES or LF − EF. The connected zero-float activities form the critical path in a basic unconstrained network.
What is float or slack in the Critical Path Method?
Float or slack represents schedule flexibility. Total float shows how long an activity can be delayed without delaying project completion, while free float measures delay that can occur without delaying the Early Start of an immediate successor.
What is the difference between critical and non-critical activities?
Critical activities directly control the calculated project completion date and normally have zero total float in a basic CPM network. Non-critical activities possess some scheduling flexibility, although they can become critical if their float is consumed.
Can a project have more than one critical path?
Yes. Two or more paths may be critical when they have the same controlling duration or no usable total float. Multiple critical paths generally increase schedule exposure because more activities can directly affect completion.
What happens when a critical path activity is delayed?
A delay to a critical activity normally delays project completion unless the lost time is recovered through another schedule change, revised logic, fast-tracking, crashing, or another effective corrective action.
Can the critical path change during a project?
Yes. Actual progress, revised activity durations, dependency changes, constraints, and consumed float can cause another sequence of activities to become critical. The critical path should therefore be recalculated as the schedule is updated.
What is the difference between CPM and PERT?
CPM primarily analyzes network logic, project duration, critical activities, and float using scheduled activity durations. PERT uses optimistic, most likely, and pessimistic estimates to represent duration uncertainty and calculate an expected activity time.
Project Management Education at AIMS
AIMS’ Project Management Academy has delivered professional education since 2005, serving learners globally through UKRLP registration and CPD and QAHE accreditation. Its internationally standardized, career-focused curriculum is taught by qualified faculty through industry-oriented teaching, practical skill development, 3D interactive learning content, and real-world case studies. Educational articles, study content, and curricula are collaboratively developed and rigorously peer-reviewed by an academic board of qualified industry practitioners. Critical path competence strengthens professional schedule planning and control. Learners can progress through an online MBA degree in project management and leadership or explore AIMS’ project management qualifications for industry-ready skills.
